Megawatts + Megabytes = MegaRisk or MegaReturn?
Alliance Intelligence Special Research Report Chapter 2
Demand — Compute Is Outpacing Efficiency
If you want to understand where the next decade of wealth will be built, don’t look at stock tickers—look at power meters.
Every revolution in human productivity has been bound by this fundamental equation:
Energy × Intelligence = Output.
For centuries, we scaled energy (coal, oil, steam, electricity). Then we scaled information (silicon, fiber, the cloud). Now we’re scaling intelligence itself, and that means scaling energy again, and at levels we haven’t yet solved for entirely.
The Great Acceleration

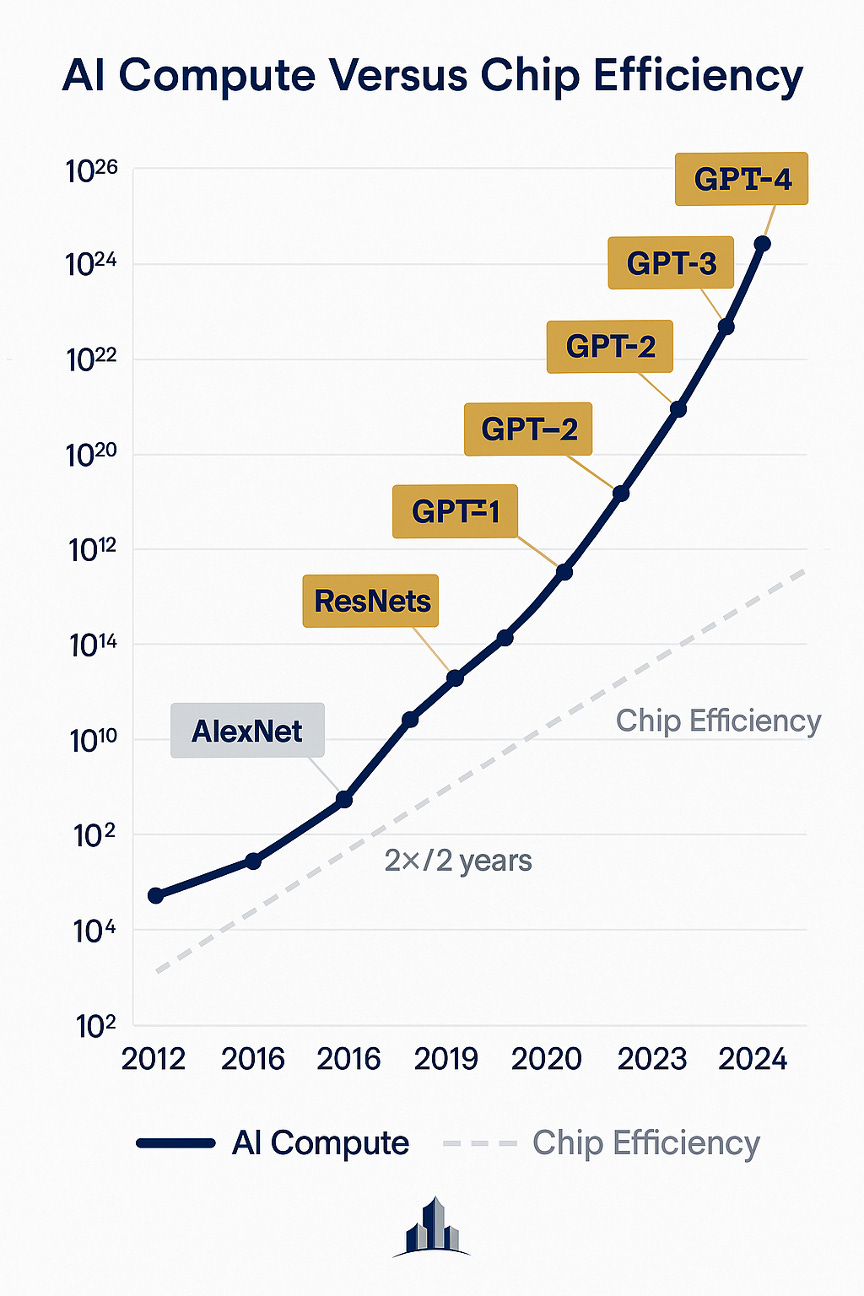

The world’s demand for compute is rising faster than any technological force in history. According to Epoch AI, the amount of compute required to train frontier models like GPT‑4 or Gemini Ultra has grown roughly 4–5× per year since 2010. By contrast, chip efficiency (measured in FLOPs per watt) doubles about every two years.
That widening gap is the core tension of the AI era. We can make chips smarter, but we can’t make physics bend fast enough to feed them indefinitely.
Here’s what that looks like in practice:
GPT‑2 (2019) required roughly 102010^{20}1020 floating‑point operations.
GPT‑4 (2023) is estimated to have required 102510^{25}1025 or more.
That’s a 100,000× jump in compute in just four years, an order of magnitude faster than Moore’s Law ever promised. Each leap forward consumes not just more processors, but more energy, cooling, and space. The marginal cost of intelligence is now physical, not digital.
From Silicon to Steel: The Physical Footprint of Intelligence
The popular myth is that AI lives in the cloud. The truth is that it lives in steel, copper, water, and electricity. A single hyperscale data center can draw 50–100 megawatts, which is the same load as a small city. Multiply that by the thousands of new AI clusters being announced worldwide, and you begin to see the challenge: we are running the biggest power land grab in modern history.
By 2030, according to the International Energy Agency (IEA), global data‑center electricity use will likely roughly double to on the order of 900–1,000 TWh per year—comparable to the current electricity consumption of medium‑sized industrial nations combined. And that’s before considering AI’s “inference era”, when billions of devices query models 24/7 in real time. In other words, the future of artificial intelligence depends on a very real and very analog constraint: watts. And remember, the end user never cares about how or where the power for their in-hand intelligence comes from until the power goes out!
The Timing Mismatch: Chips Versus Power
Beneath the headlines about record AI‑chip orders lies a quieter structural dilemma: the time clocks of silicon and power infrastructure are fundamentally out of sync.
Frontier‑class AI chips being designed, pre‑sold, and deployed today have a practical high‑value lifespan for cutting‑edge training workloads on the order of 2–4 years, while the electricity and grid capacity needed to run them at scale often takes 5–7 years to show up.
Technical and operational analyses now converge on a short useful life for top‑end AI chips. A Princeton CITP analysis notes that GPUs stressed at 60–70% utilization under AI workloads tend to last about 1–3 years in practice, even though they are often depreciated over 5–6 years on corporate balance sheets. Epoch AI finds that the median time from the release of leading AI accelerator designs (from NVIDIA V100 onward) to their last observed use in frontier training runs is about 2.3–4.5 years, with a central estimate around 3.9 years.
In other words, the “frontier” chapter of a chip’s life is short and intense, followed by a steep drop‑off in strategic value for the highest‑end workloads. Infrastructure, by contrast, moves on grid timelines, not product timelines.

Industry and advisory analyses highlight that: new grid capacity and major transmission projects typically require 4–7 years; high‑voltage transmission lines often take 7–10 years from planning to completion; and large transformers and critical switchgear now have lead times that can stretch two to four years or more in constrained markets.
This creates a structural “duration mismatch” where GPUs can be conceived, taped out, manufactured, and sold multiple generations before the power infrastructure that would run them at full load is actually energized.
This is not theoretical.
In Nvidia’s own backyard, multiple large data‑center campuses (representing nearly 100 MW of designed IT load) have been built but sit partially or fully idle waiting for sufficient grid interconnection, with local utilities targeting completion of upgrades closer to 2028. Bloomberg has reported that hyperscalers like Microsoft already have significant GPU inventories sitting underutilized or idle because the power to run them at designed scale simply is not there yet.
When you combine 2–4 year chip utility windows with 5–7 year grid buildouts, you get a simple but unsettling implication: a non‑trivial share of today’s pre‑sold chips will arrive at the socket functionally obsolete, or at least economically impaired, by the time full power shows up.
The New Compute Arms Race
This energy‑to‑intelligence race is playing out across multiple fronts:
Training Power: Frontier labs like OpenAI, Anthropic, and xAI are renting or building entire power substations just to train their models, concentrating demand into dense clusters that stress local grids.
Inference Density: Every major SaaS or cloud platform integrating AI needs dedicated inference clusters—permanent, high‑availability workloads that turn one‑off training spikes into continuous baseload demand.
Edge Intelligence: Telecoms and chip firms are deploying micro data centers closer to users, multiplying total node count and adding thousands of smaller but cumulative loads to already congested distribution networks.
Sovereign AI: Nations are racing to localize compute capacity for security and industrial policy reasons, driving redundant buildouts in parallel and amplifying pressure on regional grids and permitting regimes.
This dynamic is why power grids are now the new capital markets. Governments are competing not just for talent or chips, but for megawatts. This is why deals like this past week’s U.S.-Saudi Investment Alliance matter, but they still don’t come to closing the gap on how far we have currently outkicked our coverage.
Forward Utility: When Chips Arrive Late
For investors and operators, the chip‑versus‑power timing mismatch raises a crucial question: what is the real forward utility of silicon that cannot be fully powered within its 2–4 year peak window? Three interlocking effects are likely to define this era:
